FactCheck: will the NBN take another 20 years to complete?

Workers install a fibre optic cable for the government’s National Broadband Network (NBN). AAP Image/Dan Peled

“At the current rate of roll-out, the National Broadband Network (NBN) won’t cover the whole country for 20 years.” – Opposition Leader Tony Abbott, National Press Club, 11 August.

The above claim on the NBN has been made many times by the Opposition, including by shadow communications minister Malcolm Turnbull.

The government admits the roll-out has slowed but insists the project will be completed on schedule by 2021. The delays, it argues, are partly due to the longer-than-expected negotiations with Telstra to get access to Telstra’s infrastructure, and partly due to problems caused by the discovery of asbestos in some Telstra ducts and pits.

When contacted by Election FactCheck, Turnbull’s office disputed the government’s reasons, arguing that the interim agreements with Telstra were reached at an early stage and construction could have started sooner. Turnbull’s spokesman said a faster roll-out had been hampered by other problems, such as difficulties with workforce mobilisation.

“Despite its chronic inability to meet any construction ramps to date, the NBN continues to make the construction ramp-up steeper, with no indication how it will meet the additional construction capacity needed,” Turnbull’s spokesman said.

(You can read the full response from Turnbull’s office here.)

But let’s look at the data to see if a 20 year rollout is likely. The graph below shows NBNCo’s projected or planned total number of premises passed by fibre, wireless and satellite (blue line) and the planned number of premises passed by fibre only (orange line) from 2010 until the scheduled completion date of the NBN in 2021. (When a premises is passed, an NBN service is available, but the service is not necessarily connected). Note that some of the planned numbers have been revised by NBNCo last year, since the Company’s original planning document was released in 2010.

The graph also shows the actual total number of premises passed (red line) and actual number of premises passed by fibre (black line).

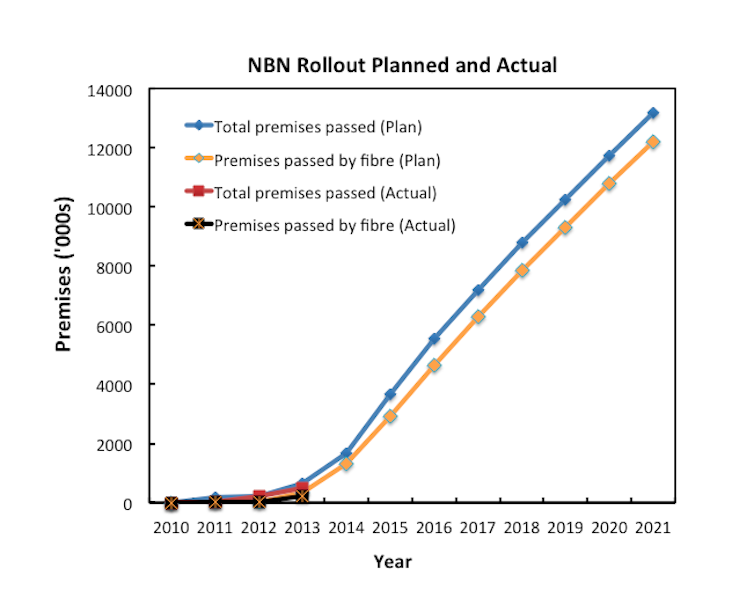

How long will the NBN roll-out take? NBNCo & Author

It is clear from the graph that NBNCo’s roll-out plan allows for a relatively slow ramp up from 2010 to 2013, with an acceleration of the roll-out in 2014, 2015, and 2016, as more skilled workers come online. Because the roll-out is still in its early stages, it is difficult to see, on the scale of this graph, the difference between the planned and actual numbers.

But we know that the actual number of premises passed by satellite in 2013 is ahead of the original schedule, and the actual number of premises passed by fibre in 2013 (207,500) lies between the planned figure for 2012 (39,000) and the planned figure for 2013 (341,000). Based on the available data, the roll-out is ramping up, but it is about six to nine months behind schedule.

We don’t have the specific calculations underlying the 20 year roll-out figure and it is hard to imagine where this number comes from. Abbott’s statement is qualified by “at the current rate of roll-out”. But the current rate of roll-out is irrelevant because NBNCo has, in fact, been able to ramp out the rate of roll-out as the supply chain for labour, materials and equipment matures and expands. There is reason to believe that the rate of roll-out will further increase in coming years.

If we take into account the fact that NBNCo is indeed ramping up its roll-out rate, and accept the government’s assurances that the reasons for the delays to date are now taken care of (which the Opposition does not accept), then it may be reasonable to expect that the orange line on the graph above will have the same shape as shown in the figure below (but be moved about six to twelve months to the right).

To illustrate this, the graph below shows the planned number of premises passed by fibre (orange line) and a copy of this line, moved twelve months to the right (orange dotted line). In this graph we have stretched the vertical axis to give a clearer view of the actual number of premises passed by fibre (black line).

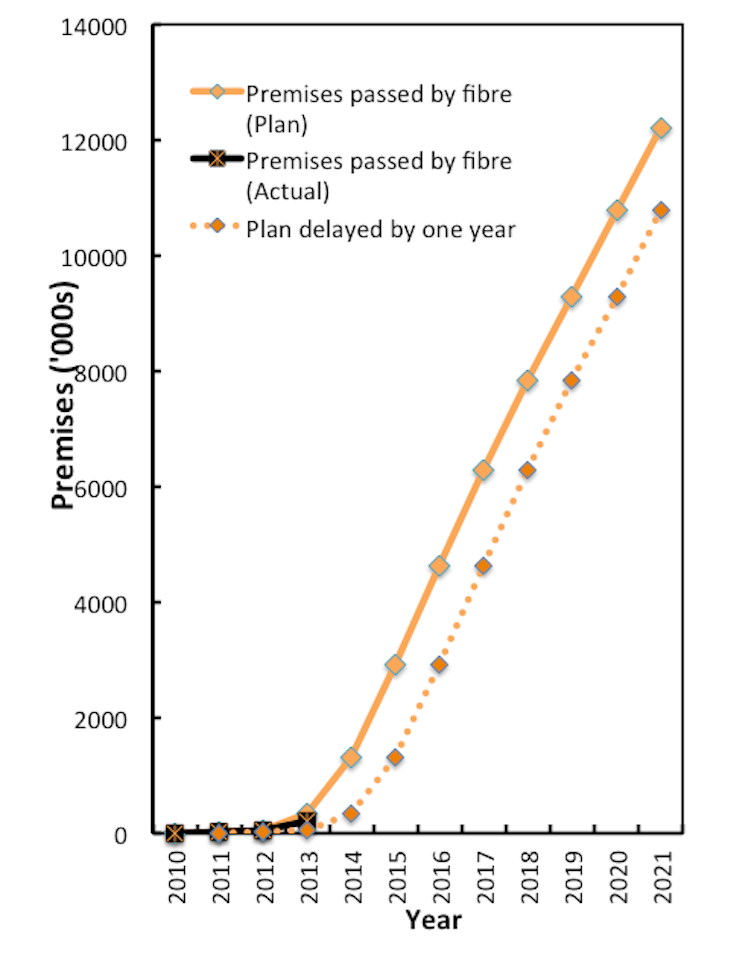

This graph shows the current delays for the NBN. NBNCo & Author

This graph shows that the actual number of premises passed by fibre in 2013 exceeds the number predicted by the dotted orange line in 2013. But the dotted orange line reaches the full 12 million premises passed in 2022 rather than 2021. Under this scenario, the time to completion would be around nine years from now.

What is clear from this discussion is that in a project lasting more than 10 years, early-stage delays do not necessarily imply a major deviation from the longer-term plan. Any attempt to project the initial activity in a major project like the NBN into the future is a fraught process.

Verdict

Predicting the future on big infrastructure projects is inherently complex. Deviations from the plan in the early stages of large projects do not automatically overturn the original timeframe. The 20-year time to completion quoted by Tony Abbott seems to be some kind of rough estimate or guess, based on unclear assumptions. It is unlikely to be correct.


Review

The analysis in this article appears quite sound.

If you take the claim literally, on the current rate completion, it will not take 20 years as Abbott says: it will take much longer. However, as the author also points out, projects like this involve an increase in the rate of roll-out; that is, an acceleration in deployment. Modelling the time taken to completion requires assumptions to be made as to the size and timing of this acceleration.

If no further problems emerge similar to the discovery of asbestos in Telstra ducts and NBNCo’s planned acceleration in deployment is achieved, then the nine years suggested in the article is a more plausible estimate than 20 years. Of course, these are substantial assumptions, but the article shows they are not unreasonable.

The key point is in the last paragraph, which says that “Any attempt to project the initial activity in a major project like the NBN into the future is a fraught process.” Without providing specific information as to his underlying assumptions, Abbott’s claim of 20 years has to be regarded as questionable. - Philip Branch
